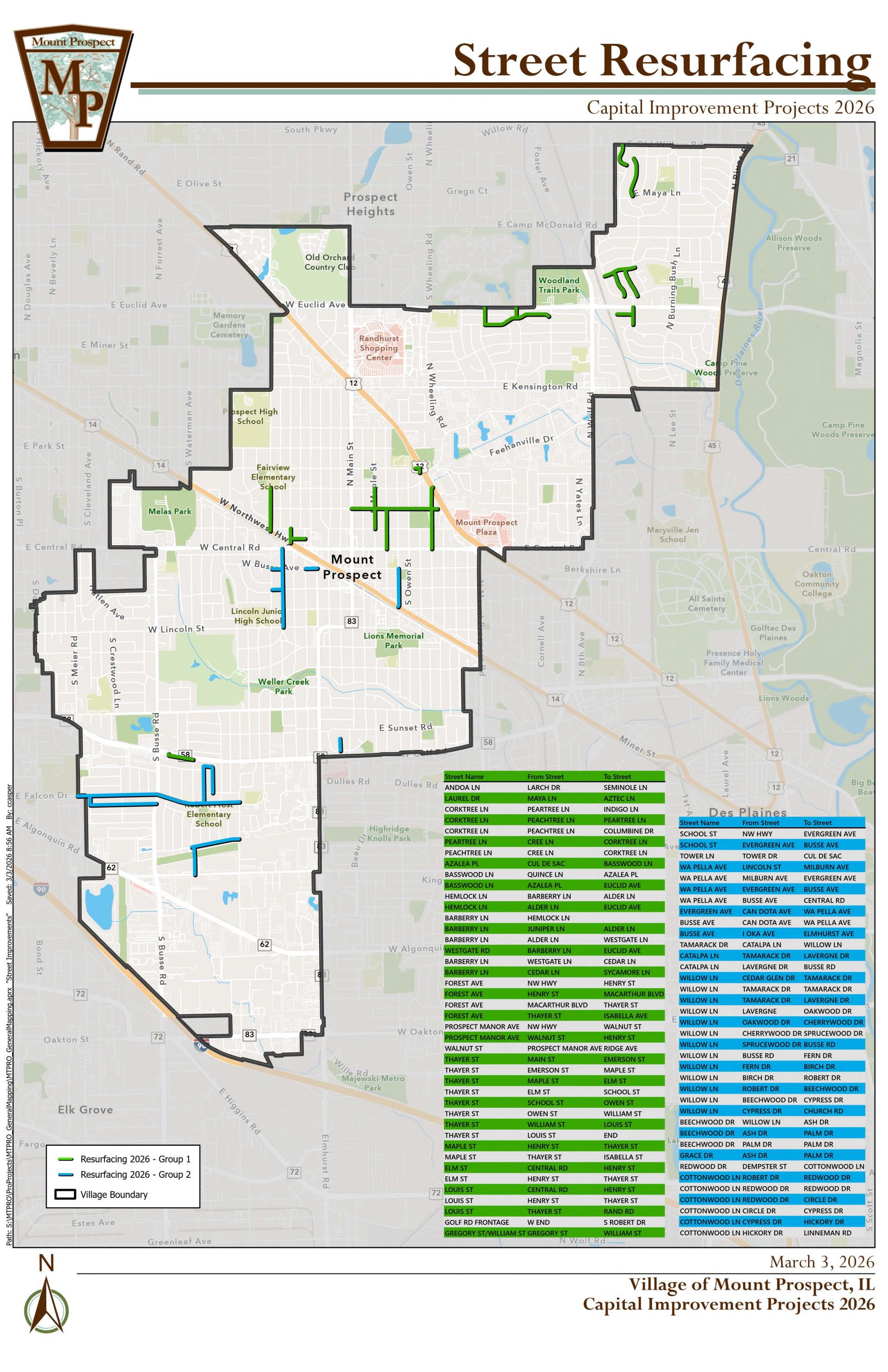

Week of April 13 (Map of work scheduled)
Sawcutting activities will continue on the following Streets:
- E Thayer St (Main St to East End)
- Gregory St & William St Intersection
Sidewalk Removals will begin in Section A
Week of April 6
Sawcutting activities will occur on the following streets:
- Hemlock Ln (Barberry Ln to Alder Ln and Alder Ln to Euclid Av)
- Westgate Rd (Barberry Ln to Euclid Av)
- Barberry Ln (Hemlock Ln to Sycamore Ln)
- E Thayer St (Main St to East End)
- N Maple St (Henry St to Isabella St)
- N Elm St (Central Rd to E Thayer St)
- N Louis St (Central Rd to Rand Rd)
Week of March 30: (Map of work scheduled)
Sawcutting activities will occur on the following streets:
- Andoa Ln (Larch Dr to Seminole Ln)
- Laurel Dr (Maya Ln to Aztec Ln)
- Corktree Ln ( Indigo Ln to Peartree Ln, Peartree Ln to Peachtree Ln, and Peachtree Ln to Columbine Dr)
- Peartree Ln (Cree Ln to Corktree Ln)
- Peachtree Ln (Cree Ln to Corktree Ln)
- Azalea Pl (Cul De Sac to Basswood Ln)
- Basswood Ln (Quince Ln to Azalea Pl and Azalea Pl to Euclid Av)
- Hemlock Ln (Barberry Ln to Alder Ln and Alder Ln to Euclid Av)
- Westgate Rd (Barberry Ln to Euclid Av)
- Barberry Ln (Hemlock Ln to Sycamore Ln)
Overview :
January 2026 - Let Group 1 and Group 2 Resurfacing Bids.
February 2026 - Award Group 1 and Group 2 Resurfacing Contracts.
April 2026 - Construction to Start
October 2026 - Substantial Completion
November 2026 - Final Completion
